Our Development Engineering team work with developers, consultants and Selwyn District Council to make sure new water and wastewater infrastructure is designed, constructed and vested to us to the right standards, so it can safely connect to our network.

Why this matters

Water and wastewater infrastructure is a long-term investment. It needs to perform reliably not just today, but for decades to come.

By setting clear requirements and reviewing designs early, we help ensure:

  • Network capacity is confirmed upfront so developments are feasible and future proofed
  • Designs meet the standards needed for safe, resilient, long life infrastructure
  • Construction issues are identified early, reducing rework and delays
  • New assets integrate smoothly with the existing network without compromising service levels

Our role is to make sure growth happens in a way that is sustainable, efficient, and fair for everyone.

Supporting growth in Selwyn

Selwyn is growing rapidly, and we recognise the important role development plays in that growth.

We are committed to working in a high-trust, collaborative environment, where:

  • Expectations are clear and met consistently
  • Feedback is welcomed and used to improve our processes
  • We support developers to navigate requirements with confidence
  • We are aligned with national standards, policies, and best practice.

What’s changed

We have updated our development engineering process to make it:

  • Clearer with defined steps and requirements
  • More consistent so applications are assessed fairly
  • More efficient reducing delays and rework where possible

These changes are based on industry feedback and our experience managing a growing network, ensuring we continue to meet the needs of both developers and the community.

Our process

We follow a clear, step-by-step process to support your development from planning through to completion.



The land development process involves several stages that ensure new infrastructure is feasible, compliant, and ready for public ownership.

Selwyn Water does not issue resource consents, but we are responsible for confirming network capacity, approving engineering designs, overseeing construction, and accepting vested assets.

In summary you need to:

  1. Confirm network capacity
    We assess whether the drinking water and wastewater networks can support your proposal. This is required before you apply for resource consent, or Engineering Design Approval (if resource consent is not required). This is done by applying for a Capacity and Connection Assessment (CCA).
  2. Obtain engineering approvals
    We review your detailed design to ensure it meets the Engineering Code of Practice and is suitable for long‑term operation. If your design package complies we will issue an Engineering Design Approval (EDA).
  3. Construct to approved standards
    Your contractor builds the infrastructure, with inspections and testing carried out at key stages.
  4. Apply to connect to the network
    Once the works pass relevant testing and inspections, we authorise connection to the public network.
  5. Complete certification and handover
    Selwyn District Council issues section 223/section 224 certificates, and Selwyn Water confirms that all water and wastewater assets meet the requirements for vesting. Section 223 and section 224 certificates apply to subdivisions only.

Not sure what applies to your project?

Please refer to the table below for guidance and some common scenarios to help you .



Your projectCCAEDARequired from the Council

Subdividing land

Creating new lots or sections

Required

Required after resource consent

Resource consent, Engineering Acceptance, s223 and s224 certificates

New or bigger connection

You need a new, upsized or non-standard water or wastewater connection, e.g. a connection outside your property boundary

RequiredRequiredPrior Engineering Acceptance (BCEA) and any building or other consent

Extra homes on your lot, same connections

e.g. adding a second dwelling, with no subdivision and no change to your existing connection

RequiredRequiredPrior Engineering Acceptance (BCEA) and any building or other consent

Commercial or industrial site using a lot of water

e.g. food processing, manufacturing, car wash

RequiredRequiredPrior Engineering Acceptance (BCEA) and any building or other consent

Building near our pipes

Any building or structure over or near our water mains, manholes or easements

Not requiredRequiredCheck with the Council whether a Prior Engineering Acceptance (BCEA) also applies

Stormwater, water races, land drainage or road works only

Not requiredNot requiredContact the Council directly
  • If your project includes a new water supply connection to our network infrastructure, you must complete a New water connection or alteration application form.
  • If your project includes a new wastewater connection to a live main, you must complete a New wastewater (sewer) connection or alteration application form.
  • Commercial and industrial sites may also require a trade waste consent.
  • A CCA is valid for six months from date of issue. An existing 2 Waters Certificate is recognised as equivalent and carries the same six-month validity. If your 2 Waters Certificate has expired by the time you apply for an EDA, you will need to obtain a new assessment.
  • 2 Waters Prior Engineering Acceptance (2 Waters BCEA) is now part of Selwyn Water's Engineering Design Approval. A 2 Waters BCEA issued before July 2026 is recognised as an EDA.

If you are unsure which row in the above table applies to your project, please contact us before you begin your design.


Common scenarios

Here are some common scenarios to help you work out which approvals and applications you may need.

A common misunderstanding is that requirements are based on the number of homes or lots. In most cases, what matters is the type of work you're doing and whether you're creating new lots through subdivision.

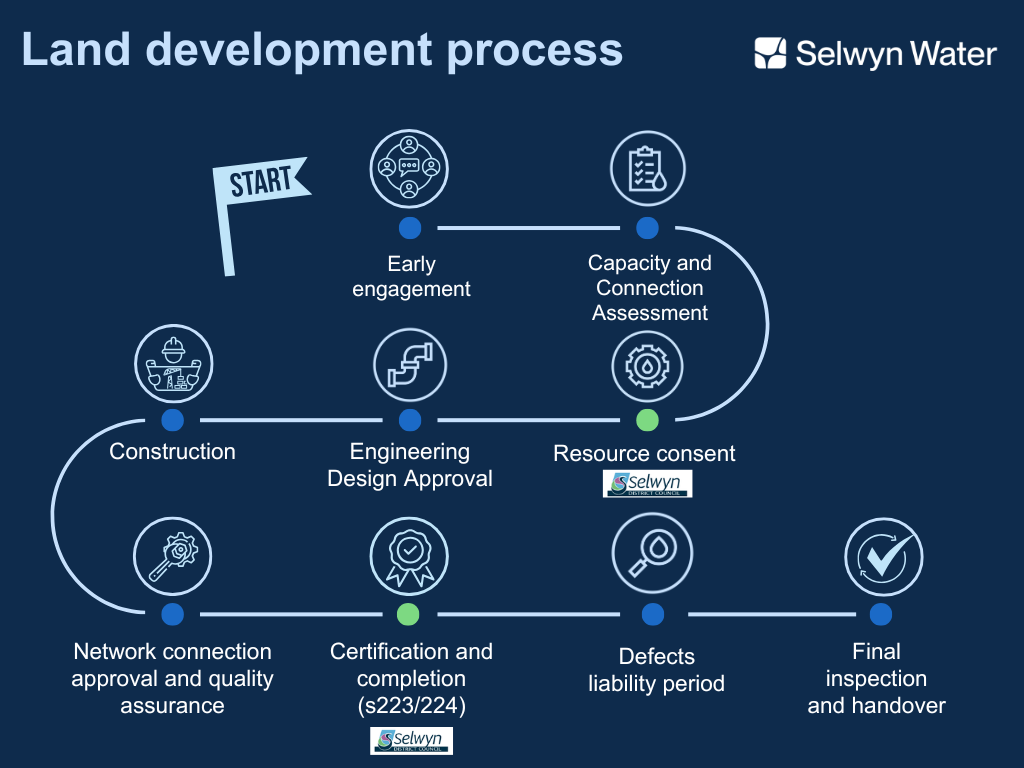

Selwyn Water land development process
